posted on 16th Nov 2024 10:38
In the last five months, Stadler has been affected by three severe weather disasters, which have had a massive impact on production. The floods in Valencia, as well as the storms in Valais and Lower Austria, have all forced Stadler to adjust its guidance.

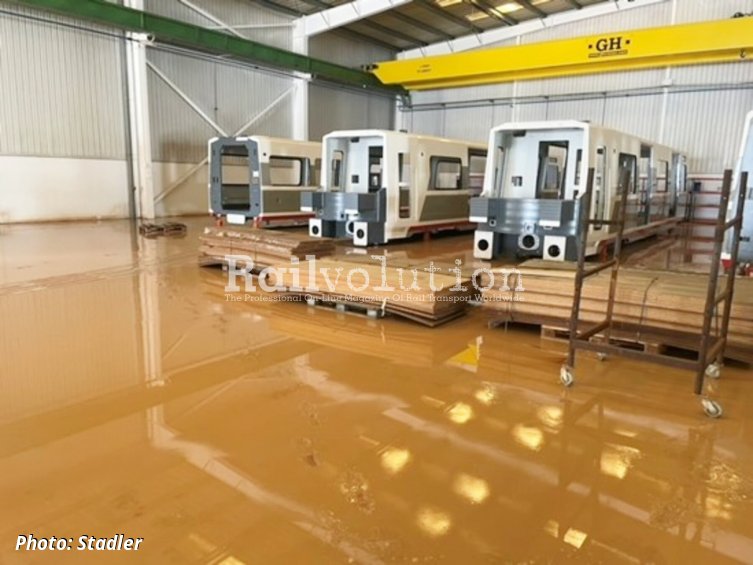

Around 3,000 employees work at the Stadler plant in Valencia, all of whom were fortunately unscathed by the storm disaster at the end of October. Around 400 employees based in the south of Valencia are currently unable to reach the works in the north of the city as roads and public transport have been disrupted, although the Stadler factory remained undamaged. Several of Stadler Valencia's external warehouses were impacted, and around 30 suppliers were badly affected, with their production halls and warehouses destroyed or flooded with mud. These suppliers have been unable to provide Stadler with the required components.
For these reasons, Stadler Valencia is currently working at a reduced pace and has to postpone between 150,000 and 200,000 production hours from 2024 to 2025. This is because of supply chains disruptions, which have meant that vehicles cannot be delivered as planned.
Supplier Constellium: delivery difficulties until August 2025

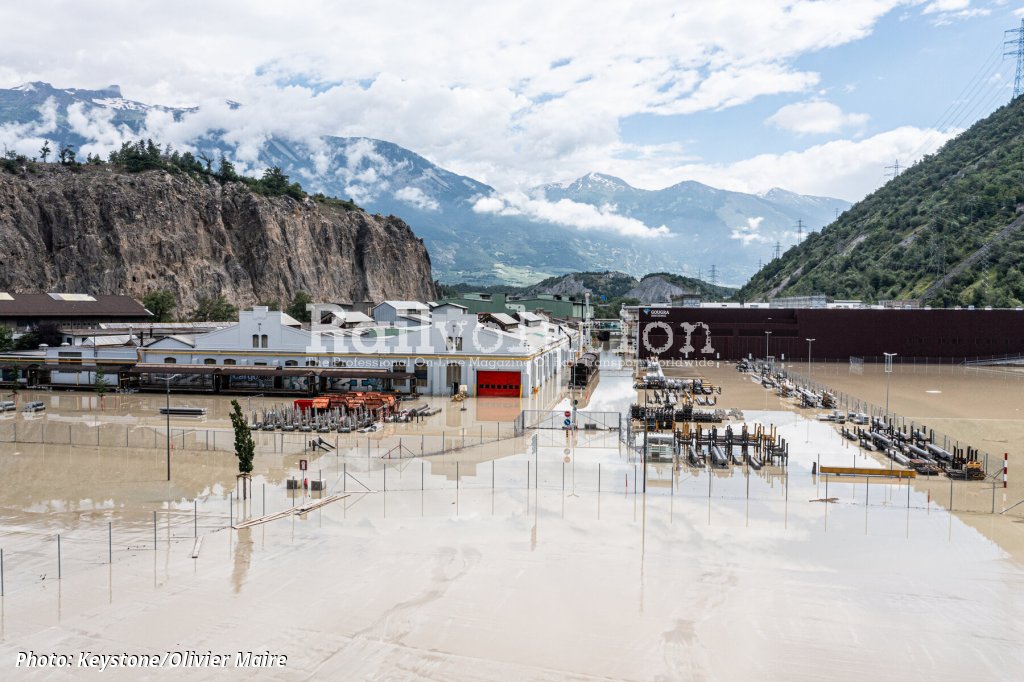

At the end of June 2024, a storm flooded the Rhone plain, including Constellium’s factory in Valais. They supply aluminium profiles to Stadler and their factory was shut down for several months. 800 tonnes of Stadler's aluminium profiles had to be disposed of. Stadler immediately took counter-measures. At the end of October 2024, Constellium was able to deliver the first aluminium profiles for the construction of bodyshells again. Constellium is not expected to have made up the backlog in the delivery of aluminium profiles until the end of August 2025.
Flooded new ÖBB KISS

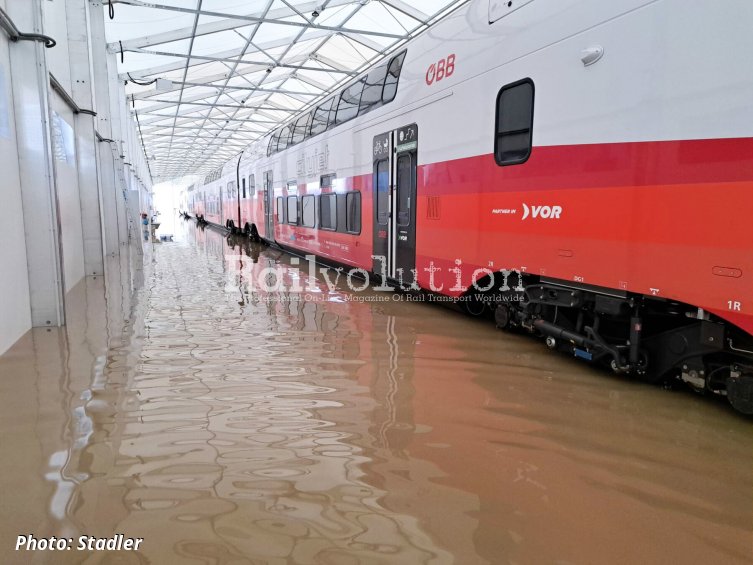

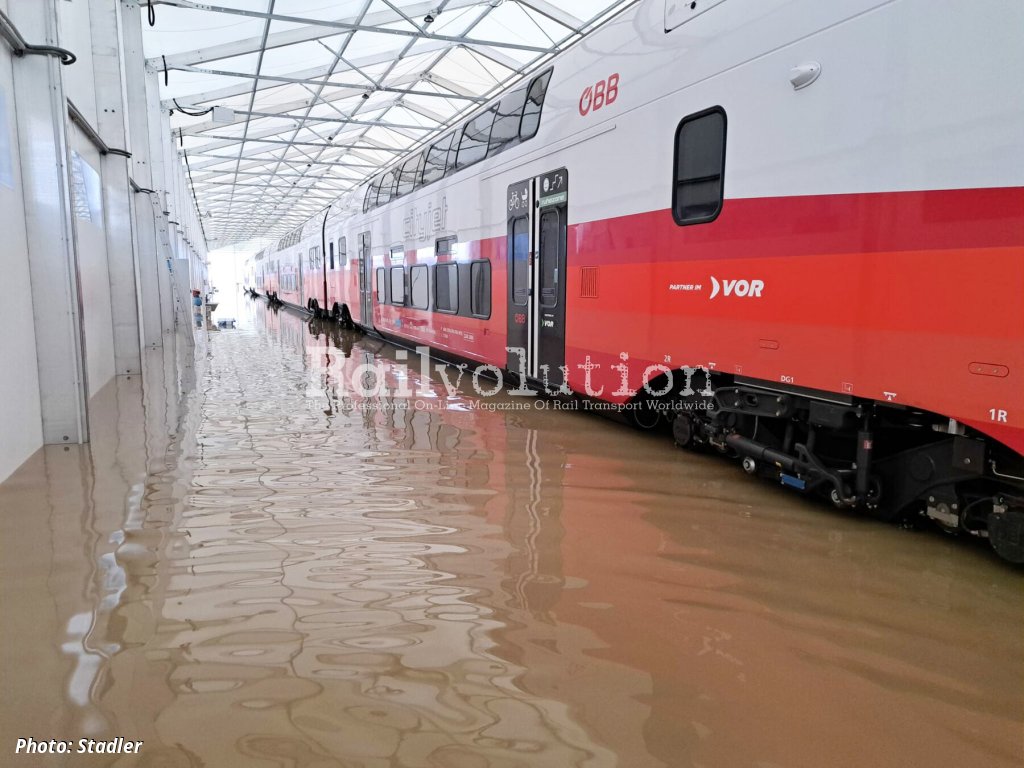

In September 2024, after days of heavy rain, a dam burst in Dürnrohr, Lower Austria, flooding the Stadler commissioning centre. The water was half a metre high. One of the new ÖBB KISS double-deck EMUs, 4734 002, was damaged as a result. Stadler told us that this train will no longer be handed over to the customer, because the KISS was destroyed as a consequence of the floods.
Delays in Berlin
Delays in the delivery of trains for the Berlin underground have also had a negative impact on the 2024 financial year. Stadler won an international tender with Berliner Verkehrsbetriebe (BVG) in 2019, which competitor Alstom had contested. This appeal postponed the signing of the framework agreement by over a year. After the framework agreement was signed in spring 2020, the COVID-19 pandemic broke out and temporarily interrupted the processing of the order. Software problems further delayed the delivery. In addition, only around 376 of the 1,500 cars have been ordered so far. This led to under-utilisation at the Berlin-Pankow works.
EBIT margin: decline by a maximum of 2 percentage points in 2024
According to initial assessments, these unforeseeable events will lead to a lower EBIT margin in 2024 by a maximum of 2 percentage points. Before these events, Stadler had expected an EBIT margin of over 5 %. Part of the 2024 revenue will be shifted to 2025, although it is not yet possible to say to what extent. However, Stadler expects that it will no longer be possible to achieve the previous revenue target of 3.5 to 3.7 billion CHF in 2024.
Outlook for the 2025 and 2026 financial years
The impact of the four events on the 2025 and 2026 financial years cannot yet be estimated. As a result of these serious events, Stadler is forced to suspend the guidance for 2025 and 2026. Once the 2025 budget and the 2026 and 2027 financial planning have been revised, Stadler will actively communicate the new guidance in the first quarter of 2025.
Order books are well filled
Stadler's order books are well filled. In the first half of 2024, the order backlog reached an all-time high of 26.8 billion CHF. Currently, 188 new orders are being processed and a further 150 orders are still in the guarantee phase.
Stadler is currently developing a catch-up programme to make up for the delays caused by the floods. During the COVID-19 pandemic in 2021, Stadler was unable to deliver 130 locomotives and trains due to travel restrictions and supply chain disruptions. Thanks to an internal catch-up programme, Stadler was able to make up for this backlog as early as 2022 and successfully complete the orders.
